Budget Cuts and Engineering Delays Threaten the ITER Global Fusion Project

The promise of limitless, clean energy has kept the world watching the ITER project for decades. Located in France, this massive international fusion laboratory aims to replicate the power of the sun. However, severe budget constraints, supply chain bottlenecks, and significant engineering flaws are threatening to derail this ambitious scientific collaboration.

The Revised Timeline: Pushing Back First Plasma

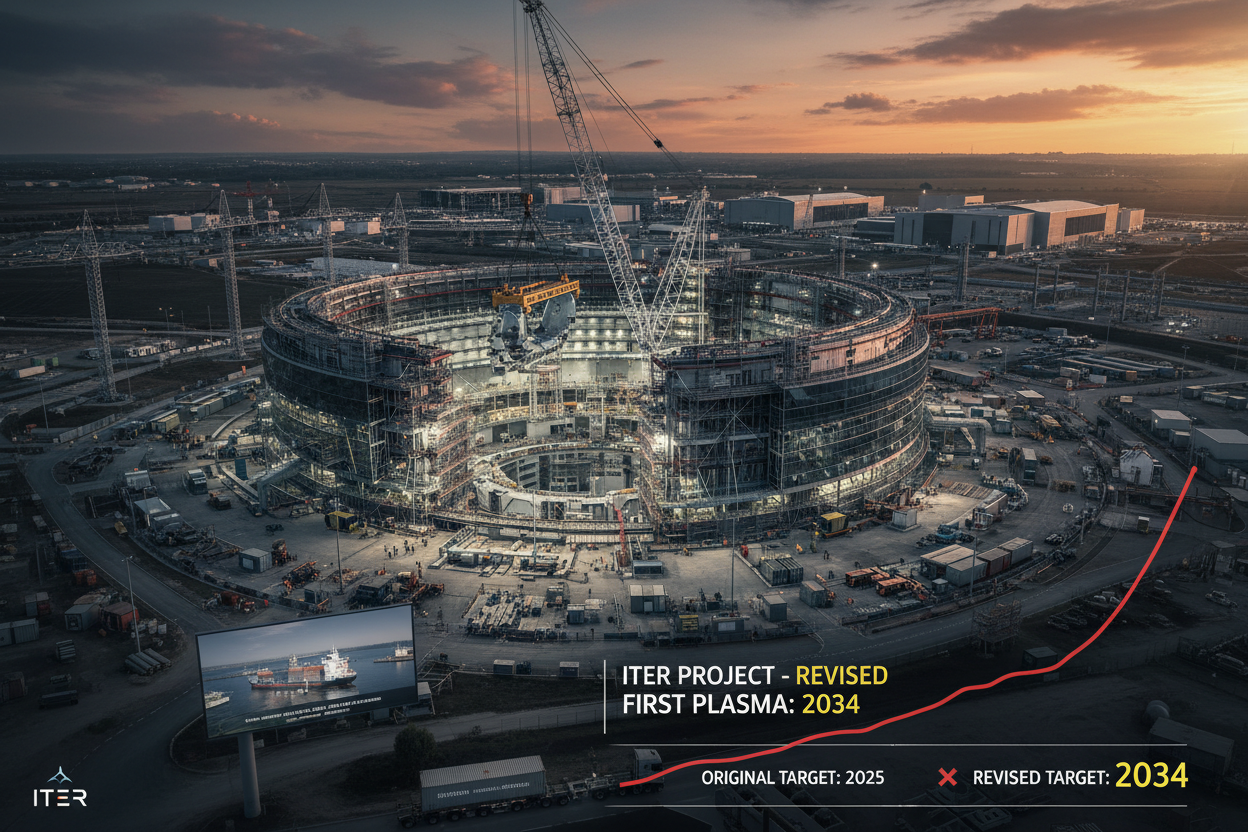

In July 2024, the project faced a major reckoning. ITER Director-General Pietro Barabaschi announced a revised baseline schedule that pushed the project timeline back by nearly a decade. Originally, the facility was expected to achieve a milestone known as “First Plasma” by 2025. Now, that target date is not expected until 2034.

First Plasma is the moment when the machine successfully heats hydrogen gas to a state of plasma, proving the basic containment systems work. But that is just the beginning of the experiment. The actual goal of generating full fusion energy, using a mix of deuterium and tritium isotopes, has been delayed until at least 2039.

This delay is not just a minor setback. It changes the fundamental expectations for when fusion power might become a commercially viable energy source for the global electrical grid.

Ballooning Costs and Budgetary Constraints

When the ITER agreement was officially signed in 2006, the initial cost estimate hovered around 5 billion euros (roughly 5.6 billion US dollars). Today, the financial picture looks entirely different. Official estimates now place the base cost at over 28 billion dollars. Furthermore, the United States Department of Energy has previously suggested the true final cost could exceed 65 billion dollars once all international contributions and labor are accounted for.

This massive price tag is creating friction among the 35 member nations funding the project. The coalition includes the European Union, China, India, Japan, South Korea, Russia, and the United States. Each member contributes specialized components and direct funding. As delays pile up, member governments are forced to ask for more money from their legislatures to keep construction moving.

The United States has seen particularly rocky funding cycles for ITER. Congress has repeatedly threatened to slash the annual contribution, citing frustration with the project management and the slow pace of construction. As domestic priorities shift, securing consistent funding for an expensive, foreign-based experiment becomes a tough political sell.

Engineering Hurdles: Flawed Parts and Changing Materials

Building a machine capable of containing plasma at 150 million degrees Celsius is a monumental engineering challenge. Recently, engineers uncovered critical manufacturing defects in key components that had already been delivered to the construction site in Cadarache, France.

These engineering setbacks require massive amounts of time and money to fix. Some of the most notable hurdles include:

  • Vacuum Vessel Defects: The massive steel sectors of the vacuum vessel, manufactured in South Korea and Europe, were found to have dimensional non-conformities. The welding joints simply did not meet the strict millimeter-level tolerances required to assemble the giant donut-shaped reactor chamber.
  • Thermal Shield Cracks: Engineers discovered stress corrosion cracking in the cooling pipes attached to the thermal shields. These shields are designed to protect the super-cooled superconducting magnets from the intense heat of the plasma. Fixing these cracks requires pulling multi-ton components out of the assembly pit, repairing the pipes, and carefully lowering them back into place.
  • A Shift to Tungsten: ITER leadership made a major design change in 2023. They decided to replace the material lining the inner wall of the reactor. The original design used beryllium, but the new blueprint calls for tungsten. Tungsten has a much higher melting point and is less likely to absorb radioactive tritium fuel. While this change improves safety, redesigning and manufacturing these new inner wall panels adds immense complexity to the schedule.

Supply Chain Fractures in a Global Collaboration

ITER relies on a highly complex, decentralized supply chain. Instead of centralizing manufacturing, the 35 member nations build specific parts in their home countries and ship them to France. This approach was designed to share technological expertise, but it has created a logistical nightmare.

When the global pandemic hit in 2020, factory shutdowns and shipping bottlenecks caused severe delays for custom parts. Moving a single 3,000-ton magnetic coil across oceans and along specialized roads in France requires months of precise coordination. A delay in one country creates a bottleneck for the entire assembly site.

Geopolitical tensions have also complicated matters. Russia is a founding member of ITER and a crucial supplier of advanced components. Russian factories provide high-tech gyrotrons, which are powerful microwave generators used to heat the plasma, as well as massive lengths of superconducting wire. Despite international sanctions following the invasion of Ukraine, scientific exemptions have allowed Russian parts to continue flowing into France. However, this political strain adds an undeniable layer of risk to the supply chain.

What This Means for the Future of Fusion Energy

While ITER struggles with its massive scale, private fusion companies are moving fast. The delays at ITER have opened the door for agile startups to attract billions in venture capital funding.

Companies like Commonwealth Fusion Systems in Massachusetts and Helion Energy in Washington state are building smaller, highly efficient fusion machines. Commonwealth Fusion Systems is using high-temperature superconducting tape to build extremely powerful magnets, allowing them to shrink the size of their SPARC reactor. They aim to demonstrate net energy gain well before ITER reaches its 2039 full-operation target.

If these private companies succeed in the early 2030s, ITER risks becoming technologically obsolete before it even finishes its testing phase. However, many physicists argue that the data generated by ITER will still be highly valuable. The giant facility will test materials, safety protocols, and plasma physics on a scale that private startups simply cannot match.

Frequently Asked Questions

What does ITER stand for? ITER originally stood for International Thermonuclear Experimental Reactor. Today, the organization simply uses the name “ITER,” which also translates to “the way” or “the path” in Latin.

Where is the ITER project located? The ITER facility is being built in Cadarache, a research center in southern France.

How is ITER funded? The project is funded by 35 member nations. The European Union contributes the largest share (about 45 percent of the cost), while the other six primary members (the United States, China, India, Japan, South Korea, and Russia) contribute about 9 percent each. Much of this contribution is provided in the form of manufactured components rather than direct cash.

Will ITER generate electricity for the public grid? No. ITER is strictly an experimental facility designed to prove that net-positive fusion energy is possible on a large scale. It will not capture the energy it produces to generate electricity for homes or businesses. Future reactors based on ITER’s research will be built specifically for power generation.
